NBIS Stock Data Center Analysis
Explore Nebius data centers, project stages and site studies. A current guide separating tenant capacity, owned developments, cloud regions and research leads.
In this article
A customer buying time on a Nebius GPU cluster is relying on much more than a server. Electricity must reach the building, cooling must carry heat away, networking must connect the machines, and the software must turn those machines into a usable service. Nebius’s infrastructure story begins with that chain. A new power agreement can enlarge the opportunity long before it adds a single hour of customer compute.
The network now combines established cloud locations, large owned developments and capacity leased inside other operators’ campuses. Those arrangements move at different speeds and carry different obligations. This guide follows every named location and research reference in Northwise’s reviewed inventory, explains what has actually been disclosed, and links to the existing site studies. The original site review dates to September 17, 2026. November updates cover Alberta, the India expansion plans and U.S. projects including Vineland and Highridge.
For location-level sources and development stages, open the Nebius Data Center Tracker. Use the directory below to move from the wider network into an individual site.

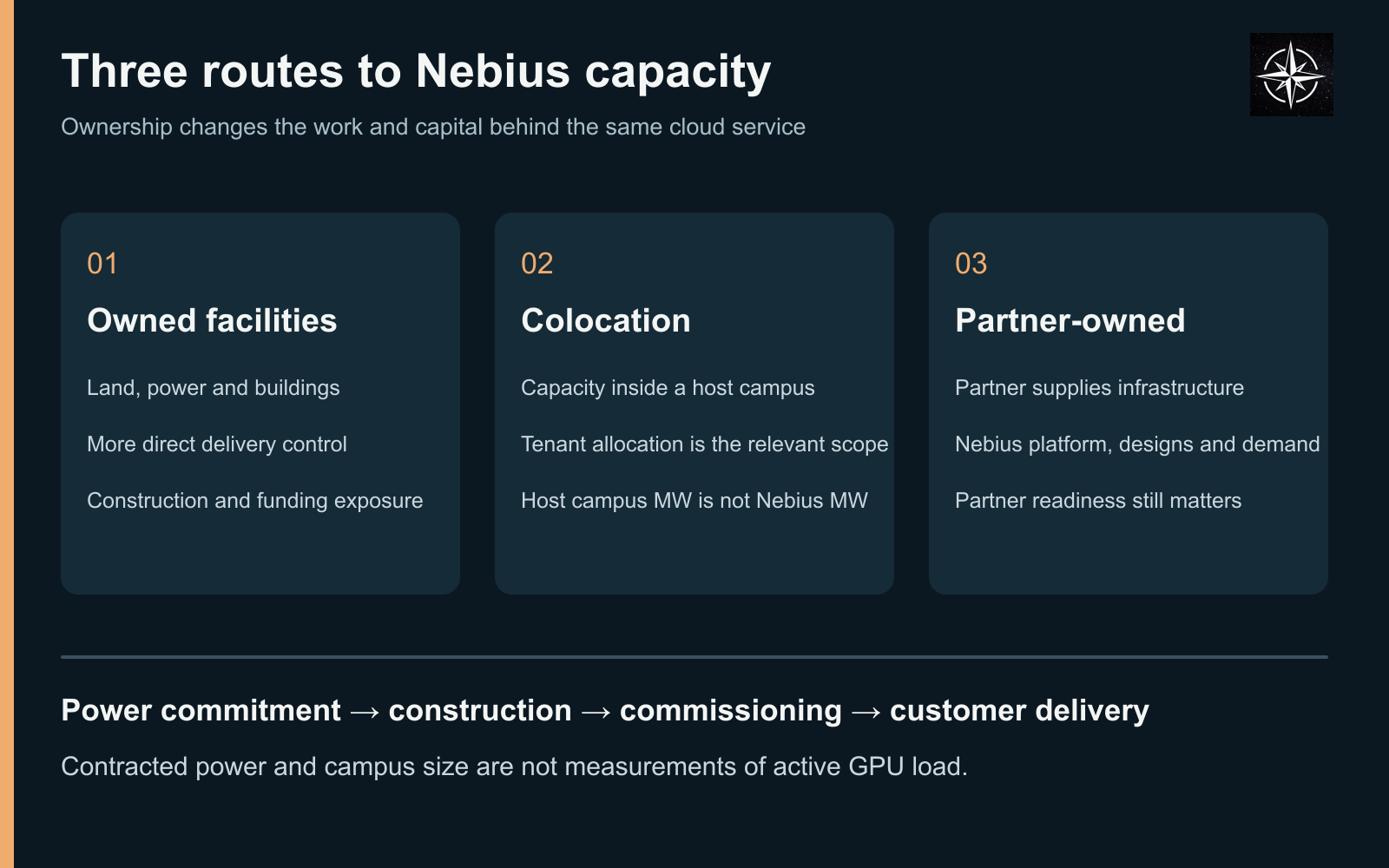

The network is expanding faster than one headline can explain
Nebius’s August shareholder letter raised its year-end 2026 contracted-power target to 5 GW and described plans to deploy more than 1 GW annually starting in 2027. These are different measures: a power commitment secures an input to future infrastructure; deployment requires the rest of the system to be built and brought into service. Neither figure should be presented as today’s active GPU load.
Nebius’s August update reported Microsoft deliveries and outlined its route to more capacity through partner-owned sites. At Vineland, that approach let Nebius put multiple tranches into service before the campus was complete. It also left the rollout exposed to DataOne’s power schedule. DataOne began winding down its temporary generation in late Q3 before Bloom could cover the gap. Nebius moved the final Microsoft tranches from the 2026 schedule to Q2 2027. November SEC filing
Sources: Nebius Q2 shareholder letter

How to read the site directory
For an owned development, the disclosed campus envelope describes the intended scale of the buildout. For a hosted deployment, the relevant figure is Nebius’s tenant allocation, which can be much smaller than the host campus. A cloud region identifies where a service is available, but it does not always provide a building address. The directory keeps those distinctions visible.

Named developments are included even when first delivery lies ahead. Hiring evidence points to Hyderabad and Chennai. The Romford entry describes a possible tenant connection. All three are excluded from confirmed operating-campus counts. Company schedules remain dated guidance until a later source verifies completion.
Nordics and Estonia
Finland combines an established engineering base with separate expansion projects. Iceland and Estonia add hosted capacity. Grouping these locations by region makes the footprint easier to follow without treating their capacity measures as interchangeable.
Mäntsälä 1, Finland
Established facility. Nebius reported completion of its expansion to up to 75 MW in March 2026. This facility envelope is not a measurement of active GPU load.

Read the Mäntsälä 1 site study · Nebius Finnish development announcement
Mäntsälä 2, Finland
Separately announced second facility, up to 70 MW, with capacity expected from 2027. It is distinct from both Mäntsälä 1 and Lappeenranta.
Read the Mäntsälä site study · Nebius second Mäntsälä announcement
Lappeenranta, Finland
Planned owned AI factory with an up-to-310 MW buildout. First customer capacity is expected in 2027; the full envelope is not operating capacity.

Read the Lappeenranta site study · Nebius Finnish development announcement
Keflavík, Iceland
The Verne-hosted Iceland deployment is represented in Nebius’s documentation as private region eu-north2. This establishes its place in the service network. The wider Verne campus remains a separate asset and its full capacity should not be attributed to Nebius.

Read the Keflavík site study · Nebius cloud-region documentation
Tallinn / Hüüru, Estonia
Greenergy / Tensor Estate identifies a 22 MW Nebius deployment targeted for late 2026. The host’s larger expansion and grid application are not additional contracted Nebius capacity.
A dedicated Northwise study is not yet available. Tensor Estate / Greenergy Tallinn programme
United States
The US network includes cloud deployments and much larger development envelopes. The difference between a customer-ready tranche and a full campus buildout is particularly important here.
Vineland, New Jersey
Microsoft is receiving capacity from Vineland, and Bloom fuel cells are supplying power. DataOne cut back temporary generation faster than planned, before Bloom could replace it. New Jersey cited 62 of DataOne’s gas engines for operating without required air permits. Nebius expects more than half of its Microsoft capacity delivered by year-end 2026 and has shifted the rest to Q2 2027. Vineland’s active IT megawatts are undisclosed. Nebius November earnings call · November SEC filing · NJDEP enforcement announcement

Read the updated Vineland site report | Open the exact tracker location | Nebius model section | Nebius project page
Independence, Missouri
Nebius has 1.1 GW under contract at Independence, including the 300 MW expansion disclosed in November. The 398-acre, four-building campus is designed for up to 1.2 GW. October permits cover the switchyard and the first building’s interior. Nebius targets a first deployment in 2027. First permanent utility power, operating IT megawatts and a customer handover quarter remain unconfirmed. Nebius Q3 shareholder letter

Read the complete Independence report | Open the exact tracker location | Nebius model section | Company project page
Kansas City, Missouri
Kansas City is the location of public cloud region us-central1 and the Patmos-hosted deployment covered in our site study. Service availability supports its role in the operating network. The host building’s full power envelope and older expansion assumptions should not be treated as a current Nebius tenant allocation.

Read the Kansas City site study · Nebius cloud-region documentation
Butler Township / Highridge, Pennsylvania
Highridge is Nebius's planned owned campus in Butler Township, Schuylkill County. Its approximately 1.2 GW ambition is phased: company power targets are 260 MW in October 2027, 660 MW in January 2029 and more than 1,000 MW in November 2029. Operating IT capacity has not been publicly quantified. Nebius addressed Pennsylvania on its November 12 earnings call and continues to list its October 2027 first power target. The expanded zoning overlay and issued environmental-permit transfers show progress, while remaining applications, final development approvals, utility works and the expansion-land record determine the delivery path. The full report includes company site drawings, the exact DEP permit entries and a phase-specific assessment of Pennsylvania's permitting and moratorium proposals.

Read the Highridge / Pennsylvania site study | Open Highridge in the tracker | Nebius research and yearly models
Birmingham / Oxmoor, Alabama
Birmingham is an owned, two-building campus under construction in Alabama's Oxmoor Valley. Local reporting describes 300 MW of project scale; active Nebius IT capacity has not been publicly disclosed. Company targets span initial commissioning in Q4 2026, operations in 2027 and construction through 2028. Issued shell, substation and high-voltage permits show progress, while interior fitout, commissioning and litigation challenging the approvals remain material delivery risks. The full report maps the campus and separate electrical parcel, follows the former Regions property's redevelopment and explains the March 2027 court milestone.

Read the Birmingham / Oxmoor site study | Open the exact tracker location | Nebius yearly models | Nebius Birmingham project
Oklahoma City, Oklahoma
Named in Nebius’s US location list. Facility address, tenant allocation and delivered compute are not established by that list. Oklahoma City is retained rather than substituting another Oklahoma hiring location.
A dedicated Northwise study is not yet available. Nebius Independence fact sheet and US location list
Woodbury / Minnesota
Nebius identifies private cloud region us-north1 in Woodbury, Minnesota. That company disclosure is the current location reference. Our earlier Minneapolis property study is an unconfirmed host-property hypothesis; its 31 MW figure does not establish Nebius’s tenant allocation or a second Minnesota campus.

Read the earlier Minneapolis property study · Nebius cloud-region documentation
CLT1 / Moore, South Carolina
At a former Bitcoin hosting site in Moore, AIB plans two 25 MW AI halls for Nebius. AIB’s November estimate puts the first in Q4 2027 and the second in Q1 2028. Spartanburg County Council authorized the development agreement on November 16. Building and zoning applications are in review and the land-disturbance application shows fees paid. AIB reports October 1 service commencement under its 65 MW utility agreement and a first escrow draw. The 50 MW of critical IT remains future capacity, with permits, financing, construction and acceptance still ahead. AIB’s quarterly filing · County project record

Read the complete CLT1 report | Open the exact tracker location | Nebius model section
France and Spain
Named host facilities sit alongside a large French development and a second French service-region reference. A region label can establish service geography while leaving the exact physical site unresolved.
Paris 1 / Equinix PA10, France
Nebius’s original Paris announcement explicitly names PA10 in Saint-Denis. This is a confirmed host identity. The facility’s total power must not be assigned to Nebius without a tenant allocation.

Read the Paris 1 / Equinix PA10 site study · Nebius Paris launch announcement
France second region / Paris II research reference
The company lists private region eu-west2 in France. A service region does not by itself identify a separate street address or campus. Paris II is a research reference pending a physical-site crosswalk.
A dedicated Northwise study is not yet available. Nebius cloud-region documentation
Béthune / near Lille, France
Azur development near Lille with an up-to-240 MW full deployment described by Nebius. Béthune and near Lille refer to the same tracked project, not two campuses. Phased construction schedules remain separate from tenant acceptance.

Read the Béthune / near Lille site study · Nebius Finnish development announcement
Madrid / Getafe, Spain
Edged confirms an 18 MW Nebius lease at MERLIN Edged Madrid-Getafe. Nebius also lists Madrid as private cloud region eu-south1. The lease is not a measured active load, and the earlier Spain-only announcement is not another site.
A dedicated Northwise study is not yet available. Edged Madrid-Getafe lease announcement; Nebius cloud-region documentation
United Kingdom
Longcross, Harlow and Newport have distinct site identities. The announced national programme must not be assigned entirely to one of them.
Longcross Park, Surrey, United Kingdom
Ark-hosted UK location covered by the existing Longcross study. Longcross is in Surrey; the previous generic London / Slough directory heading was misleading. The national expansion programme is not a Longcross-only allocation.

Read the Longcross Park site study · Nebius UK expansion announcement
Harlow / Kao Data, United Kingdom
Kao Data announced a 22 MW, ten-year Nebius agreement on June 8. The site study is available below. The agreement is a tenant commitment, not evidence that all capacity is already serving customers.

Read the Harlow / Kao Data site study · Kao Data Harlow agreement
Newport / Vantage CWL1, Wales
Vantage and Nebius announced the CWL1 deployment agreement on August 13. The announcement identifies the site but does not allocate a specific MW figure to Nebius.
A dedicated Northwise study is not yet available. Vantage and Nebius Newport announcement
Israel
Tenant IT allocations, hardware announcements and the host operator’s campus plans describe different layers of the Israeli footprint. The entries below retain the source chain behind each claim.
Modi’in, Israel
Nebius announced a 4,000-HGX-B200 deployment in October 2025. Keep the stated hardware units separate from the host campus power and from older modeled MW estimates.

Read the Modi’in site study · Nebius Modi’in deployment announcement
Beit Shemesh, Israel
Mega Or’s annual report specifies a 58 MW IT tenant allocation, with phased delivery targeted from Q3 2026 to Q1 2027. The filing leaves the tenant unnamed; Globes reports Nebius’s confirmation of the agreement. Host-campus expansion figures describe a different scope and do not prove tenant acceptance.

Read the Beit Shemesh site study · Mega Or FY2025 report, section 4.1.3; Nebius confirmation reported by Globes, January 6
Masmiyya / Masmiya, Israel
The same annual report specifies a 22 MW IT tenant allocation with Q3 2026 delivery guidance, linked to Nebius through the reported company confirmation. Masmia and Masmiyya are spelling variants, not separate sites. The planned date alone does not establish achieved active compute.

Read the Masmiyya / Masmiya site study · Mega Or FY2025 report, section 4.1.3; Nebius confirmation reported by Globes, January 6
Canada
Alberta
Nebius disclosed exclusive site rights for a planned 100 MW multi-campus Alberta program, with delivery targeted for 2027 and room to scale to several hundred megawatts. The campus locations, power arrangements and capacity basis are open.

Read the Nebius Alberta Data Center report · Nebius Q3 shareholder letter
India

Nebius expects its first two Asia-Pacific colocations to open in India in 2027. Hiring points to Hyderabad and Chennai. The company has yet to name either city, host or tenant capacity. Read Nebius India Data Centers
Hyderabad, India
Deployment engineers and technical project managers are being recruited in Hyderabad. A July trade publication also named a conceptual Nebius project in the city.
Hyderabad tracker entry · Project Reporter, July 20 issue, page 22 · Nebius recruitment index
Chennai, India
Nebius advertised a dedicated on-site Chennai warehouse role to receive GPU racks and supply its data center engineers. This local job is separate from the earlier multi-city deployment posting.
Chennai tracker entry · Nebius warehouse posting · Nebius recruitment index · Nebius APAC expansion announcement
OXAGON, Saudi Arabia
HUMAIN and DataVolt propose up to 50 MW for Nebius in the first 100 MW now under construction on the Red Sea. The preliminary framework targets a phased start from Q4 2027. DataVolt’s 1.5 GW long-term plan covers the whole campus. Any larger Nebius allocation would require a further agreement.
Read the OXAGON site report · Joint project announcement · Oxagon tracker entry
Unresolved tenant and project leads
Romford is an inferred tenant connection. In Rotterdam, VOLT has announced the project and Nebius operating capacity remains unconfirmed.
Romford and Rotterdam
Romford, United Kingdom. Green Mountain announced a 14 MW agreement with an unnamed neocloud at LON-East. The host has confirmed the contract. Its announcement leaves the identity of the tenant open, so Northwise excludes this entry from confirmed Nebius capacity.
Green Mountain’s LON-East announcement
Rotterdam, Netherlands. VOLT is developing an AI campus in Rotterdam. Northwise follows it as a potential source of future capacity for Nebius. The size of the proposed campus alone tells us little about how much compute Nebius could offer there. VOLT’s Rotterdam project · Rotterdam tracker entry
What the location count can and cannot tell us
The directory includes developments, cloud regions and research leads. Some entries describe planned facilities or locations that remain unconfirmed. Mäntsälä’s second project is distinct from its first facility. Béthune and near Lille describe the same development. Woodbury is a company-disclosed service region, while the Minneapolis property hypothesis remains unconfirmed.
Seven older announcement references also remain in our source history: Spain, Finland, two UK references, France and two Israel references. They may overlap the locations now identified by name and are not seven additional campuses. The UK programme’s unnamed member is not automatically Romford; France’s second region is not automatically a separately located Paris building.
What to follow from here
Our reading of the footprint is that Nebius is building optionality through several delivery routes, while the decisive constraint remains getting complete systems into customer service. Power agreements, building completion, equipment installation and contract delivery each remove a different obstacle. A credible update should identify which obstacle has actually been removed and for which project.
The next useful disclosures are confirmed tenant identities for unresolved hosts, more precise allocations where only a city or region is named, and achieved delivery milestones at developing campuses. These would improve the evidence base without requiring an invented utilization estimate or a new valuation scenario.
Continue the research
Use the Nebius company page for the wider Northwise research library, company overview and separately published models. The filtered tracker below provides the location-by-location view.
Reader discussion
Discuss the research
Create a Free account to join the discussion with a display name.
Create a Free Account




No comments yet. Start a thoughtful discussion.
