Northwise

Nebius Highridge: Pennsylvania's Path to a 1.2 GW AI Campus

Research Note · FreePublished · Updated

Nebius has cleared the zoning gate for the full planned Highridge footprint. The back half is more credible, but final land, development, and grid approvals still separate 1.2 GW from reality.

In this article

Nebius site network | Highridge in the tracker | Nebius research and models

Along Interstate 81, the warehouses at Highridge Business Park tell the story of what this part of Pennsylvania has become: a place where large industrial sites, transport connections and regional infrastructure meet. Nebius wants to add a different kind of factory to that landscape. Instead of moving physical goods through a distribution center, its proposed campus would turn electricity into computing capacity for AI customers.

The ambition is enormous. Nebius describes a roughly 600-acre, 1.2 GW development in Butler Township, Schuylkill County, near Gordon and Frackville. A campus on that scale would give the company room to build and expand its own infrastructure over multiple hardware generations. It would also make Pennsylvania a substantial part of Nebius's transition from renting capacity wherever it becomes available to controlling more of the facilities behind its cloud. Nebius project overview.

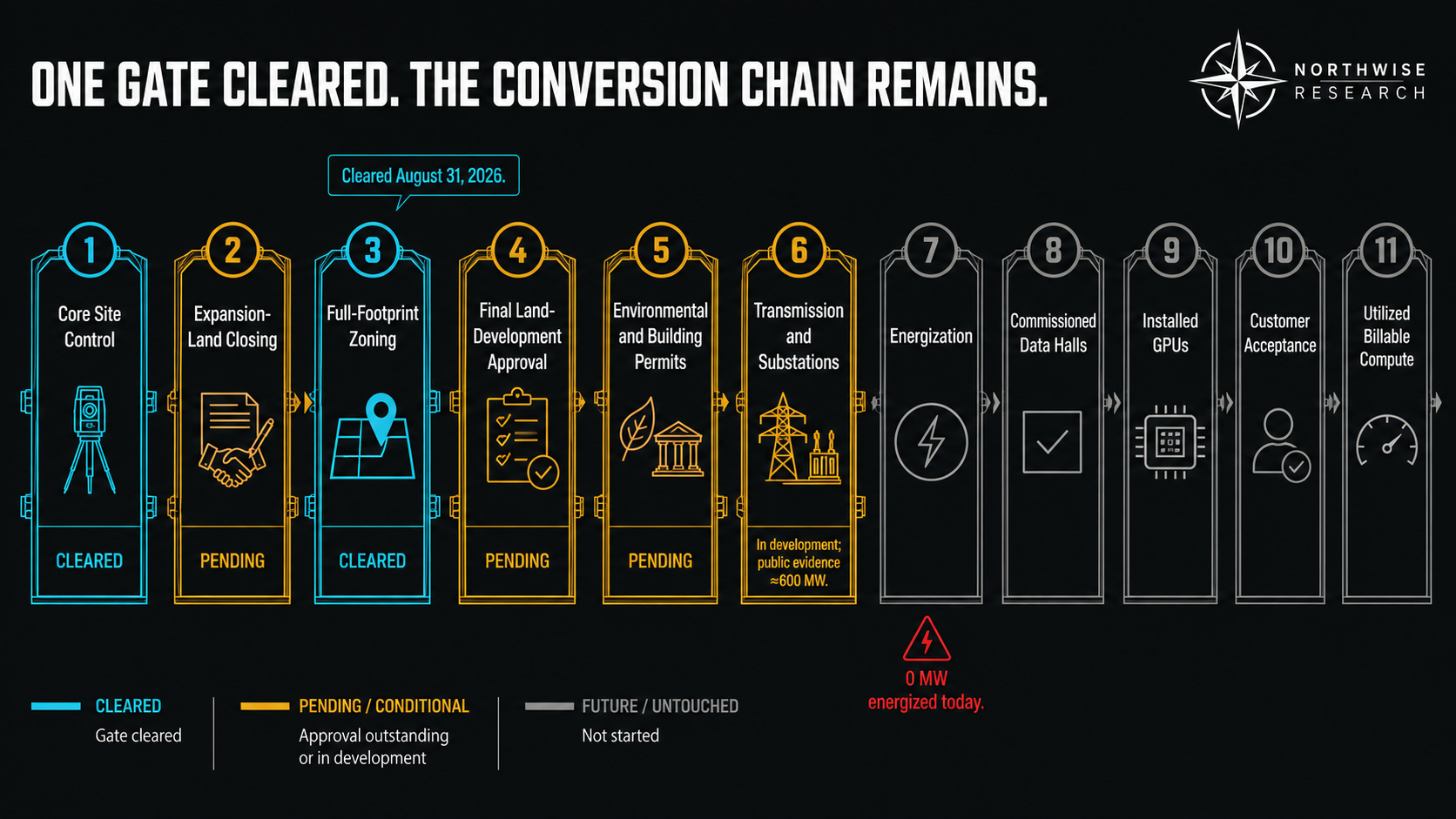

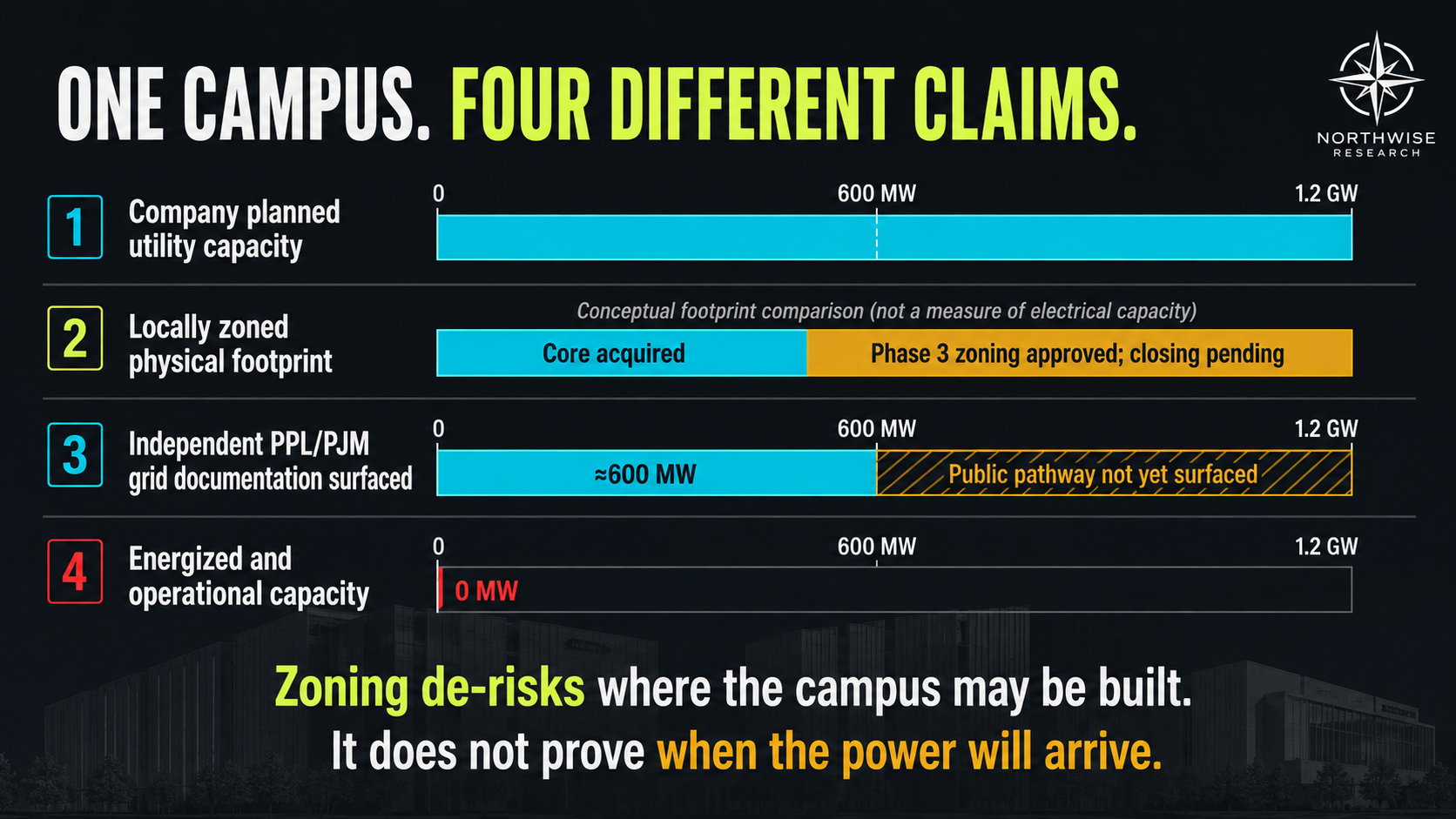

Highridge has moved beyond an announcement. There is an acquired core property, an expanded zoning district, transferred environmental permits and a phased company power schedule. The difficult work is now in the connections between those pieces: approving the final development, completing the electrical infrastructure, fitting out buildings and bringing customer equipment into service.

The balance is better than a speculative land option with a gigawatt label, but less advanced than a fully permitted campus approaching commissioning. Pennsylvania's own permit tracker still shows an amendment pending and several permit categories awaiting submission. That is where much of the next round of progress needs to appear.

Where Highridge stands today

The company targets its first 260 MW for October 2027. Its project page describes that milestone as the initial operational phase, while the detailed FAQ presents the sequence as power delivery. Those descriptions do not establish how much customer-ready IT load will be commissioned on that date. No operating Nebius IT capacity or Highridge-specific revenue has been publicly disclosed.

On the November 12 earnings call, Nebius infrastructure chief Andrey Korolenko discussed Pennsylvania as a campus expected to be going up in 2027, with potential to contribute to future revenue. The Q3 deck specifically named Missouri, Lappeenranta, the second Mäntsälä site and Alabama in its list of new owned sites expected to deploy capacity in 2027. Highridge's own project page still lists October 2027 for the first power milestone. The gap between the utility milestone and customer acceptance leaves the amount of Pennsylvania revenue in 2027 open. Q3 earnings call transcript · Q3 shareholder deck · Highridge project schedule.

The distinction matters because the 1.2 GW ambition describes the eventual scale of the development. It is not capacity already serving customers, and it is not a single delivery due in 2027.

Measure

Current position

What it means

Full campus

Company plan for approximately 1.2 GW

Long-term development scale; the gross-power versus IT-load basis needs clarification

First company milestone

260 MW in October 2027

Power-delivery target, with an initial operational phase described by Nebius

Later company milestones

660 MW in January 2029; more than 1,000 MW in November 2029

Cumulative power targets, not additional tranches to add together

Operating IT capacity

Not publicly quantified

The current record does not support a measured active-MW figure

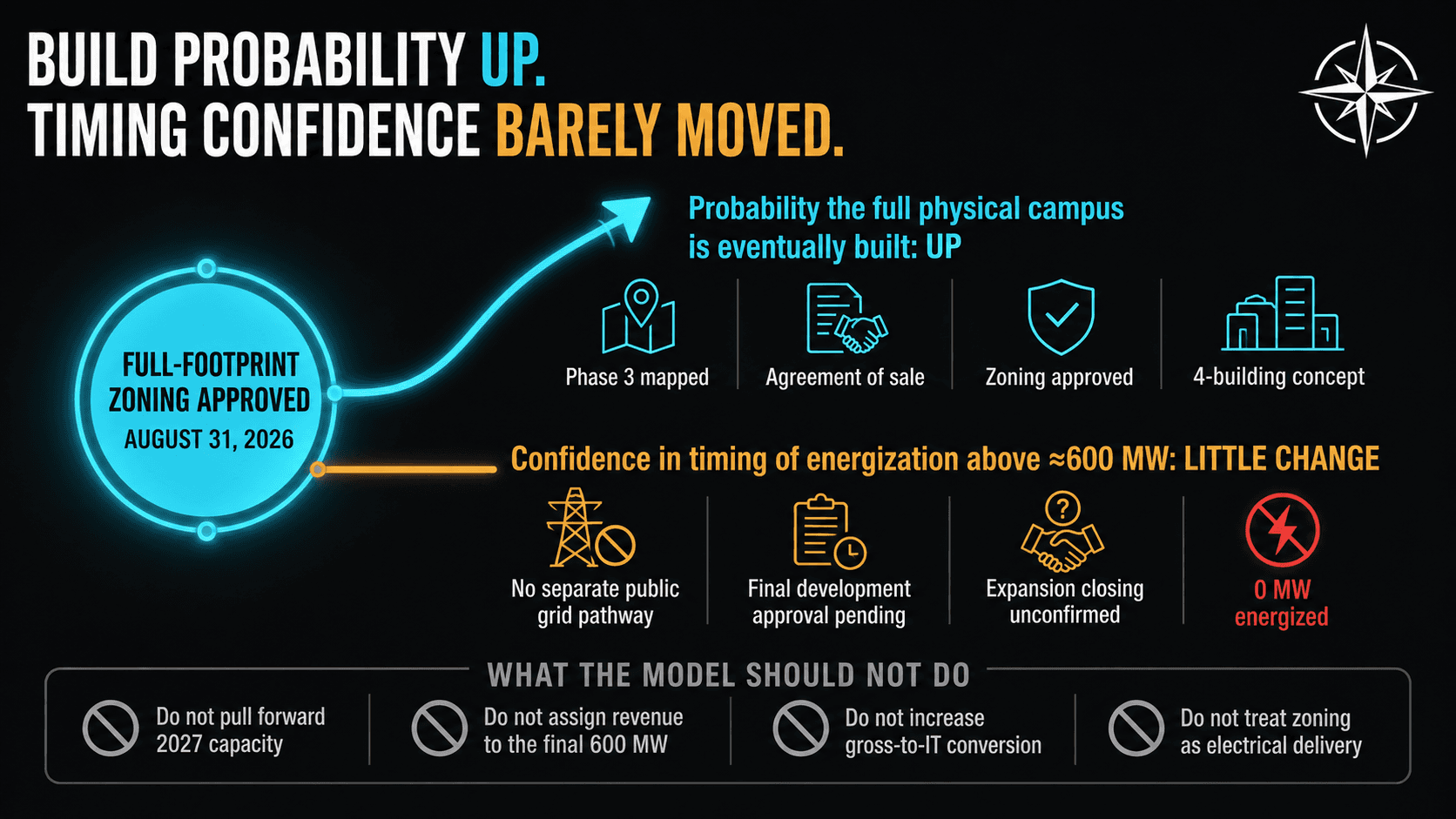

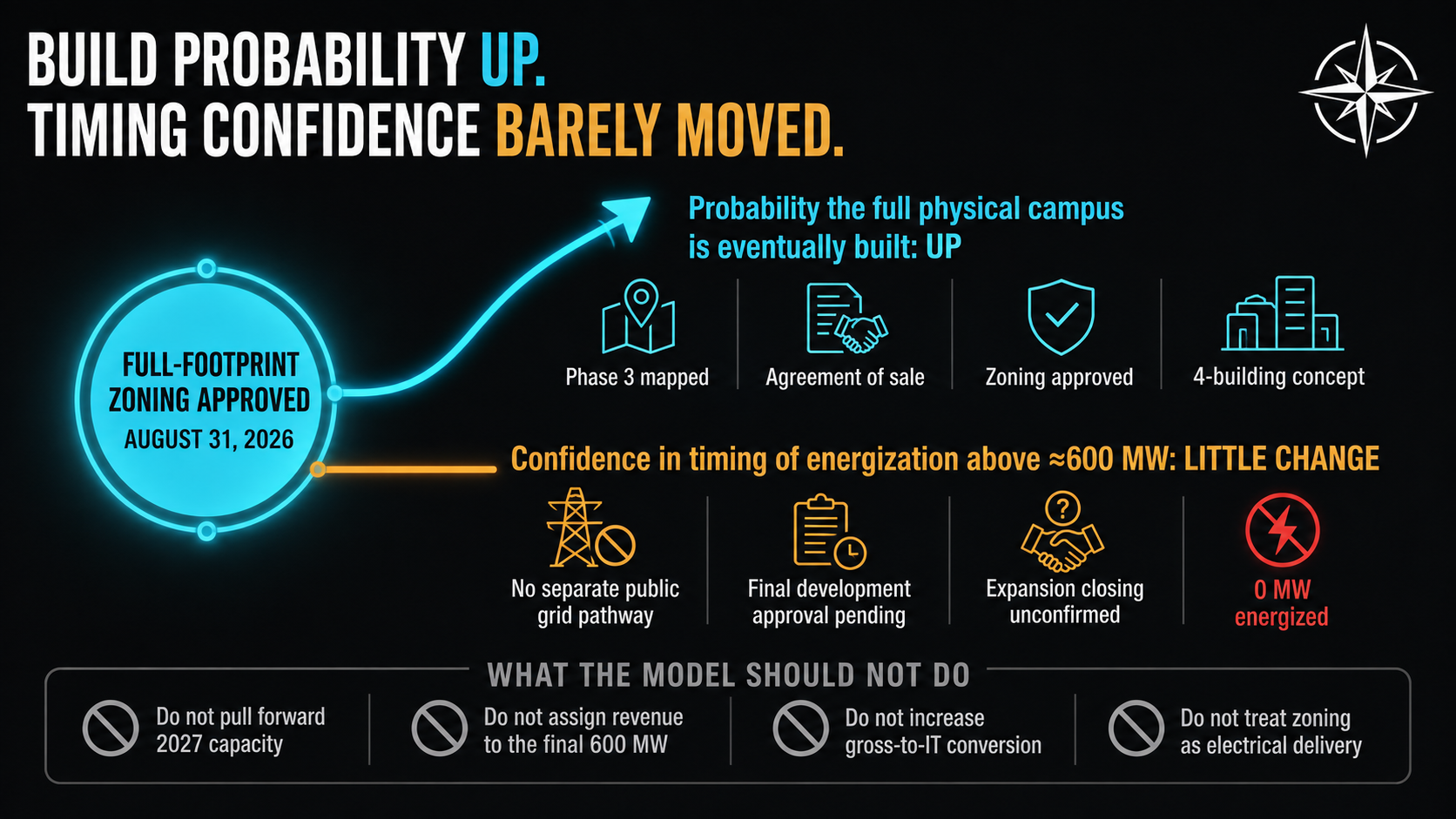

Local land use

Overlay expanded August 31, 2026

A zoning advance; final development and construction approvals are separate

Environmental permitting

DEP lists the project under review

Two issued transfers, one pending amendment and five entries not yet submitted as of November 18

Site-specific customer and revenue

Not disclosed

Company-wide contracts should not be assigned to Highridge without a site disclosure

Sources: Nebius project schedule, August zoning hearing coverage and Pennsylvania DEP's project tracker, project DC54-022. The DEP dates discussed below are application-submission dates, not permit-issuance dates.

Nebius Highridge cumulative company power targets: 260 MW in October 2027, 660 MW in January 2029 and more than 1,000 MW in November 2029. Operating IT capacity is not publicly quantified.
Company power targets, not measured operating IT capacity. The milestones are cumulative and should not be added together. Revenue follows commissioning and customer acceptance.Northwise; company targets from Nebius

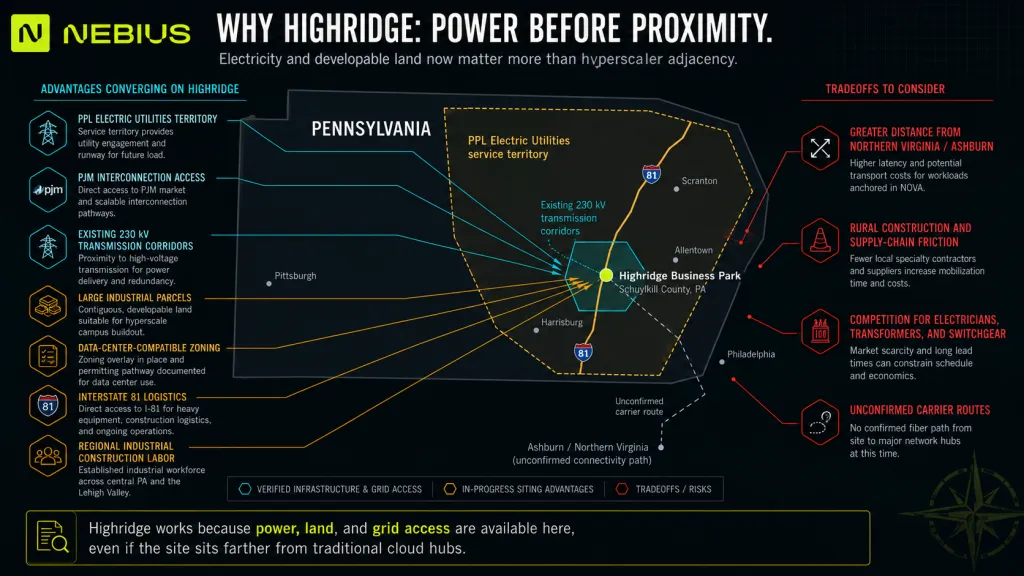

The place, the land and the expansion

Highridge sits in Pennsylvania's anthracite region, in an established business park alongside I-81. Gordon Mountain Road and Highridge Park Road frame the development area. The industrial setting helps explain the attraction: large parcels, road access and existing regional electrical infrastructure offer a starting point that would be difficult to assemble inside a dense metropolitan market.

It also gives the project a local history beyond AI. Highridge was an industrial-development proposition before Nebius arrived. The earlier NorthPoint development is still visible in the state's permit records, which identify this project as “Highridge Data (NorthPoint Development) Project Nebius.” Nebius is taking an existing development footprint in a new direction, with a much more demanding electrical load and a different set of environmental and community questions.

The land story has two parts. Local parcel reporting described three acquired core parcels totaling roughly 358 acres and a $187.5 million transaction earlier in 2026. The remaining expansion land was reported as SEDCO-owned at the August 31 hearing, under an agreement of sale conditioned on the zoning change. Clearing that condition improved the route to the larger campus; it did not itself record a completed land transfer. A subsequent closing for that expansion tract has not been established here. Original parcel reporting; September 1 hearing account.

Nebius's own property overview makes the distinction easy to see. Phases 1 and 2 occupy the northern portion of the concept, beside I-81. Proposed Phase 3 extends west and south along the existing industrial park. The map explains why a successful start on the core property and completion of the entire 1.2 GW plan are different milestones.

Nebius property overview showing Phases 1 and 2 beside Interstate 81 and proposed Phase 3 extending west and south along Gordon Mountain Road and Highridge Park Road.
Nebius property overview presented August 6, 2026. The drawing distinguishes Phases 1 and 2 from proposed Phase 3. It is a company concept map, not a recorded deed or confirmation of a later land closing.Nebius, Building With Schuylkill County, slide 7

The full footprint gives Nebius expansion room. It does not require every part of the property to be ready at once. That flexibility can support staged investment and different customer deployment schedules, provided the early phases can operate independently and the utility and permit boundaries match the construction sequence. The final approvals and engineering plans need to establish those dependencies, rather than leaving investors to infer them from a shaded map.

What the campus is designed to contain

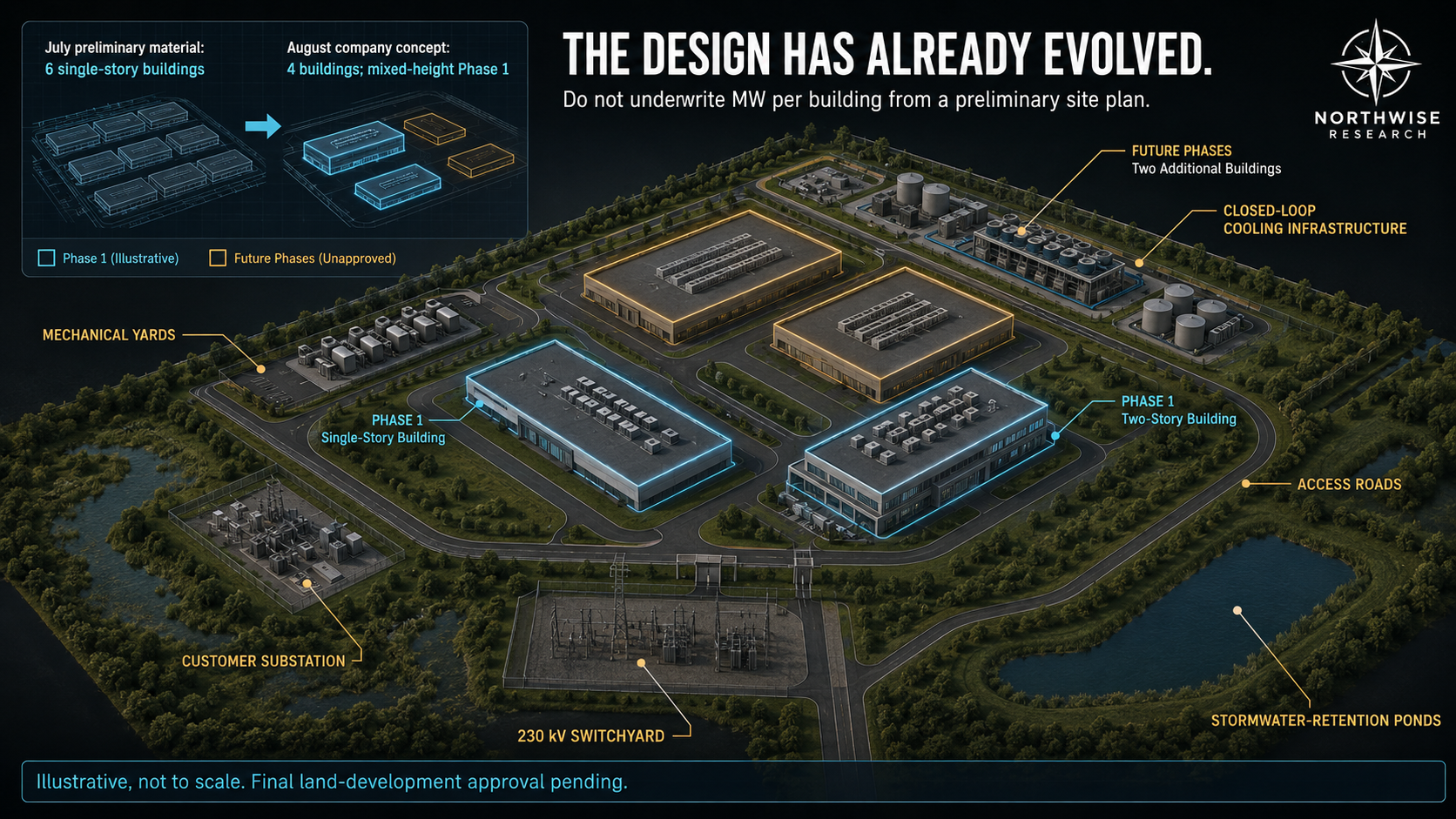

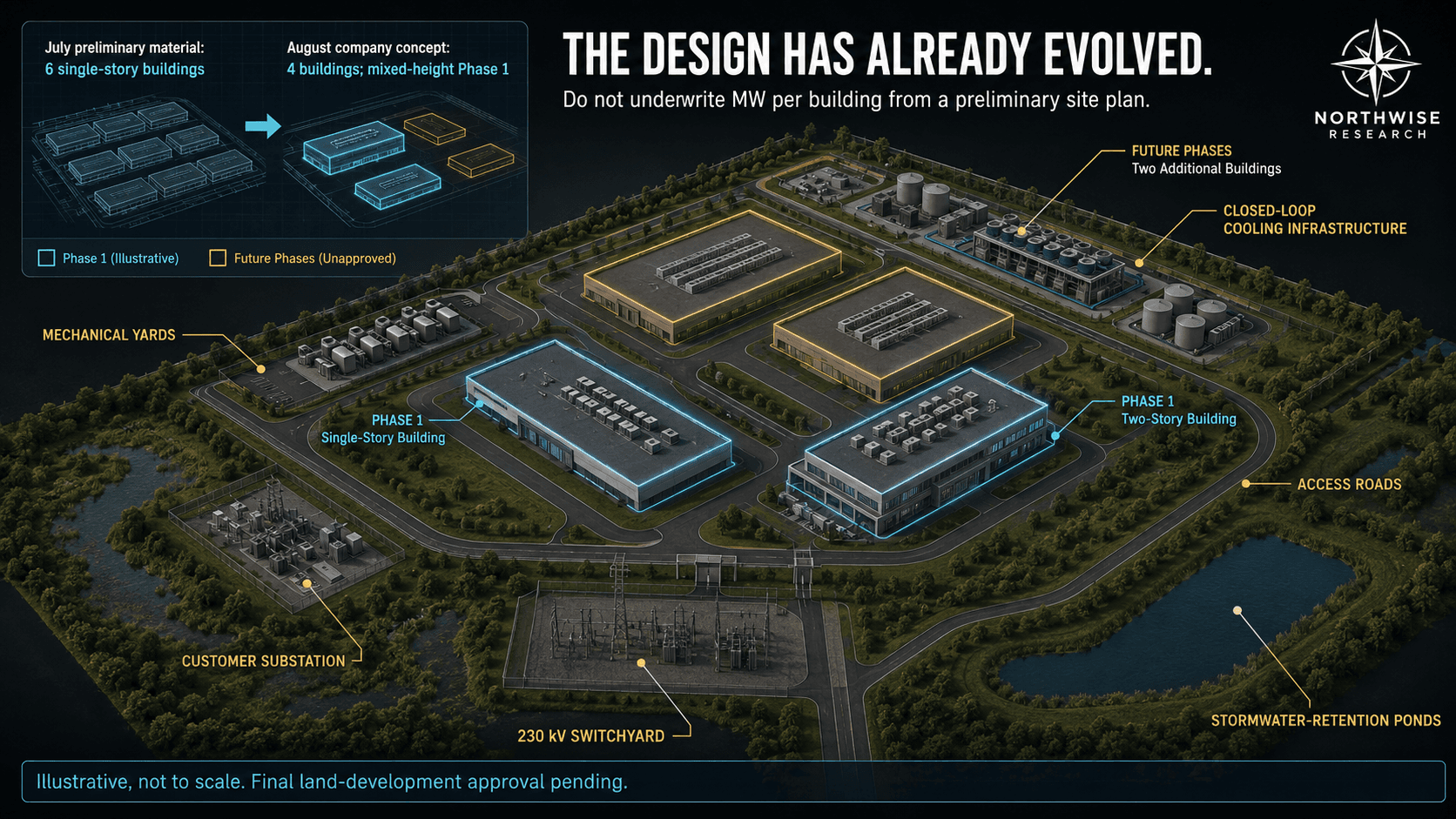

Nebius's August 6 open-house presentation describes a four-building design and shows a detailed draft layout for Phase 1. The drawing contains a one-story Building 1, a two-story Building 2, an electrical substation and switchyard, wetlands and water-retention areas. Its July 2026 draft label remains important: this is a company design drawing, not a stamped approval or a picture of completed construction. Company open-house presentation, property overview and Phase 1 drawing.

Nebius July 2026 draft Phase 1 plan showing a one-story Building 1, a two-story Building 2, substation and switchyard, wetlands and water-retention areas.
Phase 1 draft site plan dated July 2026, presented at the August 6 open house. Reproduced with its draft label intact. This is not an approved permit drawing or a construction-completion map.Nebius, Building With Schuylkill County, slide 10

The electrical and water infrastructure occupy meaningful space alongside the computing buildings. That is a useful reminder of what a large AI campus actually requires. The halls are only part of the investment. Power must arrive at the right voltage, be transformed and distributed through redundant systems, and be paired with cooling, network connections and equipment that can operate reliably under sustained loads.

Owning the campus gives Nebius more influence over those choices. It can design around the mix of training and inference workloads it expects to serve, coordinate building systems with successive GPU deployments and expand within a coherent site plan. The trade-off is that Nebius also carries more of the construction, financing and delivery responsibility.

A four-building concept does not establish an equal allocation of megawatts to each building. Nor does the appearance of two buildings in Phase 1 prove they will be commissioned together. The building-by-building load, rack configuration and acceptance sequence remain important future disclosures. Assigning precise GPU counts from the campus power headline would skip all of those steps.

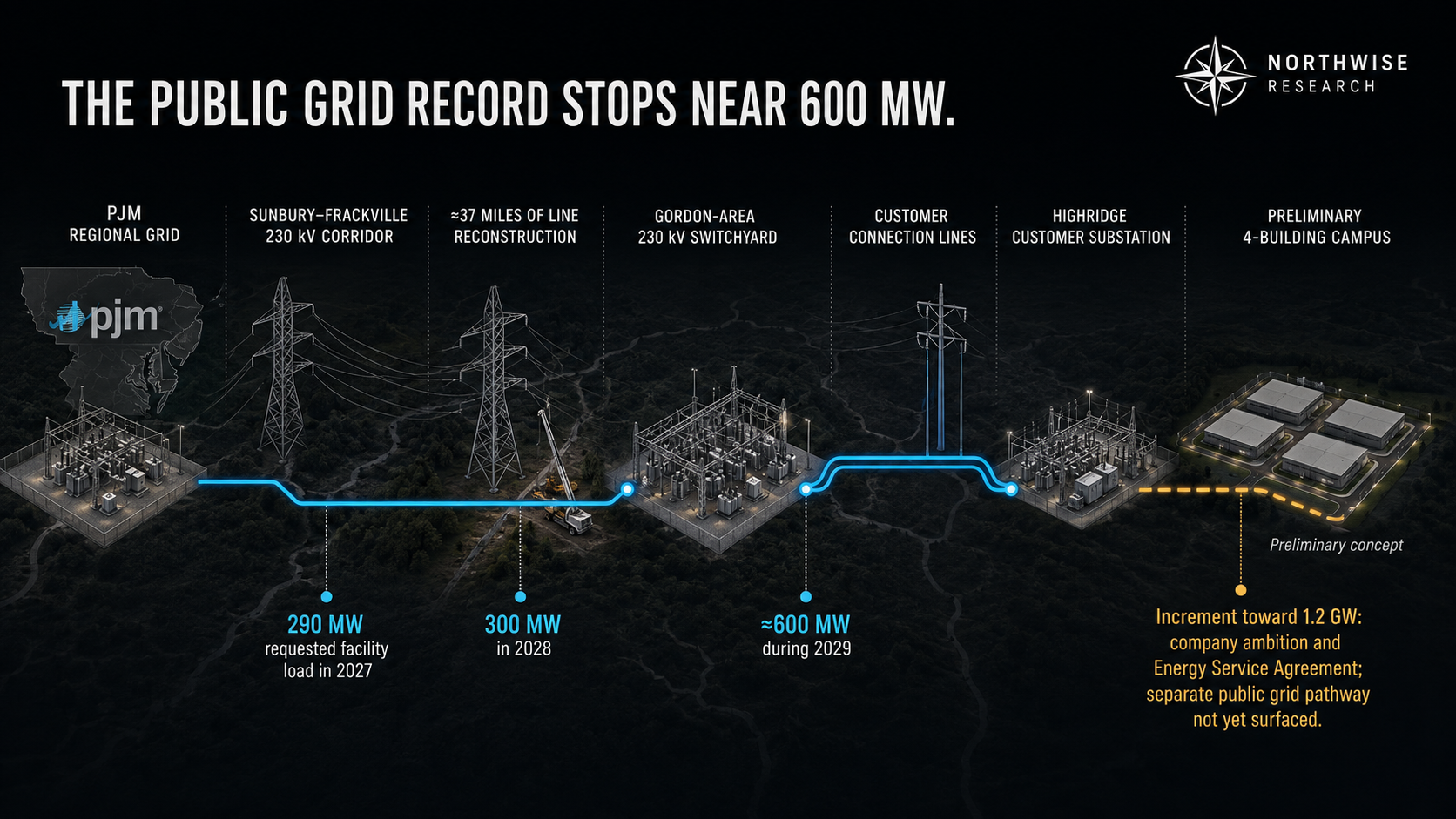

The electrical route into Highridge

Nebius's fact sheet describes an agreement with PPL to deliver 1.2 GW, with the company paying for its power requirements. That is the company's account of the commercial arrangement. The public transmission-planning record offers a separate, narrower view of the infrastructure being considered in the Gordon area. Nebius Pennsylvania fact sheet.

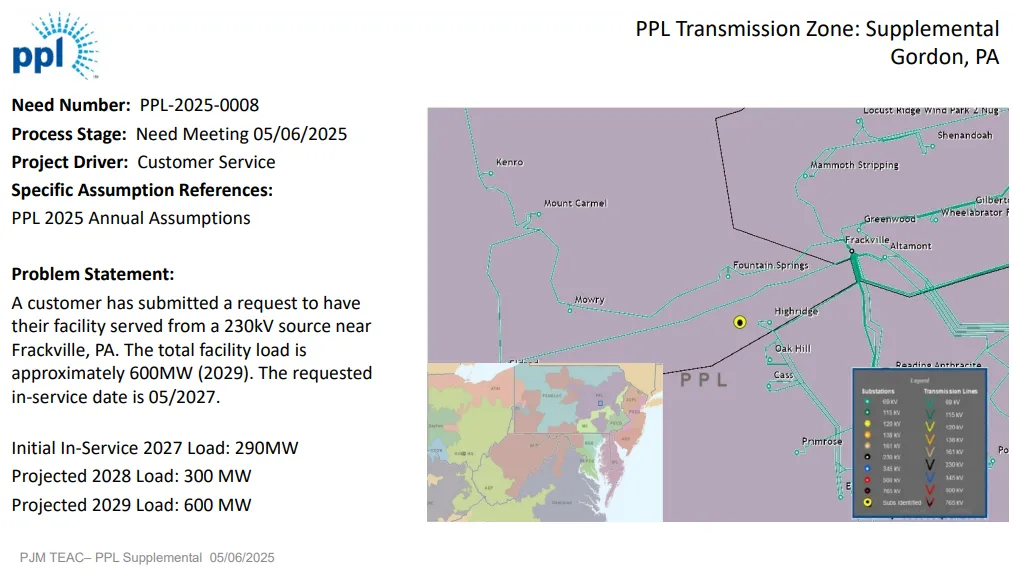

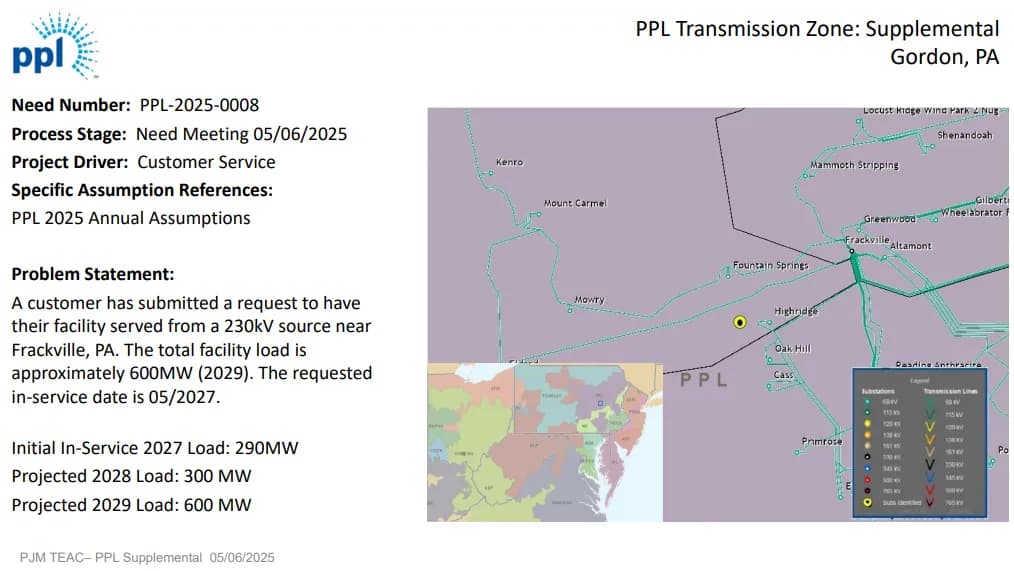

In May 2025, PPL presented need PPL-2025-0008 to PJM's Transmission Expansion Advisory Committee. It described an unnamed customer near Frackville seeking service from a 230 kV source, with 290 MW of facility load in 2027, 300 MW in 2028 and approximately 600 MW in 2029. The requested first service was May 2027. This is a supplemental transmission-planning need number, not a generator-interconnection queue position. PPL's May 6, 2025 need presentation, page 7.

The location, scale and timing make Highridge a plausible match for that request. The filing does not name Nebius, so the connection remains an inference. It should not be used as an independently confirmed allocation of power to this specific campus.

An October 2025 solution presentation for the same need sets out the physical work: a new Gordon 230 kV switchyard, substation modifications, approximately 36.5 miles of line rebuilding across the Sunbury, Eldred, Gordon and Frackville sections, and three short customer lead lines. It carried a $231.65 million transmission estimate and a projected May 30, 2027 in-service date. The filing explicitly called the project conceptual. PPL's October 8, 2025 solution presentation, pages 5 and 6.

That record helps explain the nature of the task. Supplying a campus this size can require work across a regional electrical system, not just a connection at the property line. It also predates Nebius's May 2026 announcement, showing that the local load-planning process was already under way before the company publicly introduced Highridge.

The estimate is not a disclosed Nebius construction invoice, and the old conceptual date is not a current construction-completion certificate. A later utility status update, the customer-service documentation and actual energization milestones would provide stronger evidence of delivery. The full 1.2 GW company plan extends beyond the approximately 600 MW load described in this particular filing.

Most importantly, the two schedules should remain separate. Nebius's 260 MW and the unnamed request's 290 MW are not the endpoints of a verified first-phase range. Nebius's 660 MW and PPL's 600 MW are not interchangeable descriptions of the same measured capacity. They come from different documents, dates and definitions.

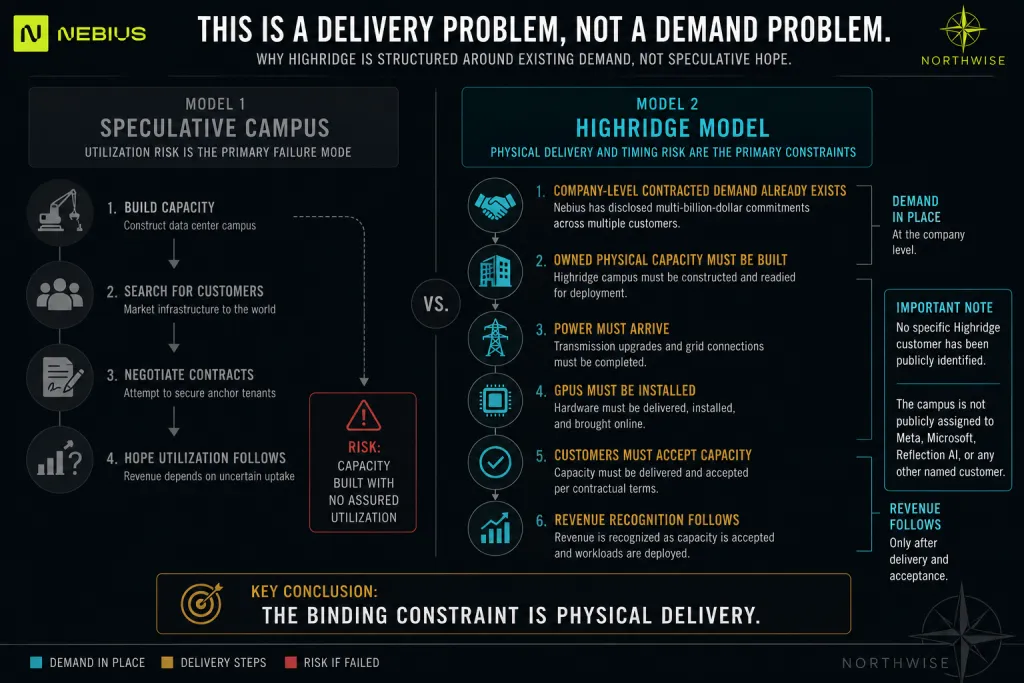

From electricity to computing revenue

Electricity arriving at the switchyard is a major event. It does not finish the campus. Buildings, cooling, electrical distribution, network equipment and GPU clusters must all be ready, tested and accepted before the capacity can reliably serve customers.

That sequence is especially important for the first company target in October 2027. Even if a power milestone lands on schedule, the amount of revenue recognized during that calendar year depends on how much usable capacity is commissioned and when customers accept it. A late-year opening should not be treated as twelve months of contribution from the entire first phase.

The later targets are cumulative: 660 MW by January 2029 and more than 1,000 MW by November 2029. They describe a substantial acceleration over time, with the full-campus ambition reaching approximately 1.2 GW. Adding those figures together would count the same earlier capacity repeatedly.

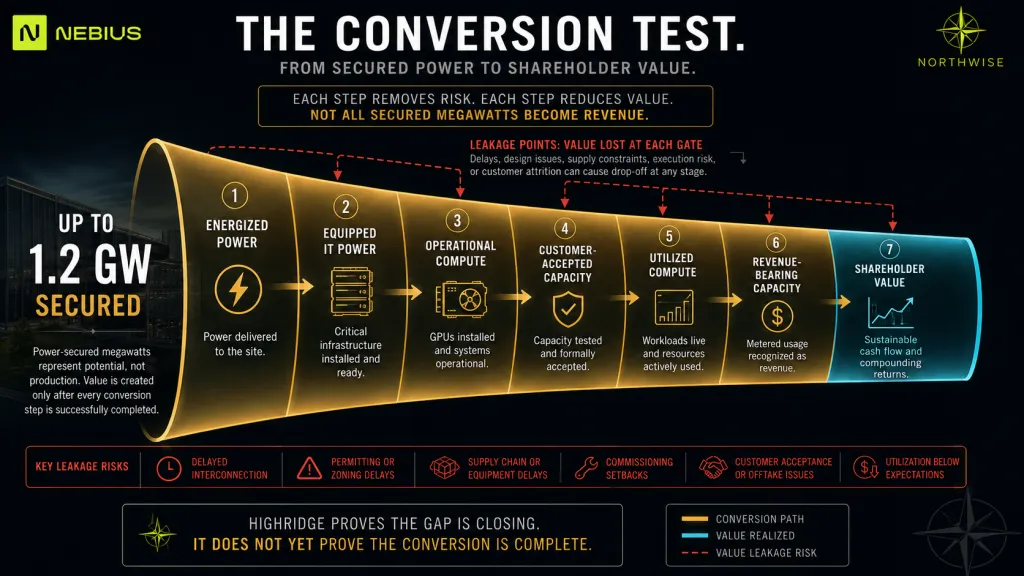

For an investment model, the useful sequence is delivered power, available IT load, installed equipment, contracted customer capacity, acceptance and time in service. The relationship between power and IT load also depends on facility overhead. Highridge has not supplied enough site-specific engineering detail to justify applying a precise conversion as fact.

These are the inputs that should eventually connect the site report and tracker to the Nebius yearly models. Each year's valuation needs the capacity that can actually contribute in that year, with its associated investment and financing. A long-term campus ceiling alone cannot provide that answer.

The permit record is more specific than a zoning headline

The August 31 votes expanded the data-center overlay and tightened the local noise limit. They established a clearer land-use framework for the larger development. They did not grant final permission to construct the whole campus. Contemporaneous hearing coverage.

Pennsylvania DEP lists Highridge as under review in Butler Township, Schuylkill County, under project data ID 10000015. Its November 18 permit file shows the same eight entries as on November 9. DEP tracker · Project data · Permit data.

Permit or category

Application type and submission

Status in the DEP retrieval

PAD540030, Chapter 102 Individual NPDES

Transfer submitted May 18, 2026

Issued

PAD540030 A-1

Minor amendment submitted August 7, 2026

Pending

E5402222-003, Water Obstruction and Encroachment

Transfer submitted May 8, 2026

Issued

Water Obstruction and Encroachment amendment

No submission date listed

Not yet submitted

Clean Water Permitting

No submission date listed

Not yet submitted

Air Quality Permitting

No submission date listed

Not yet submitted

Site Specific Installation Permit, storage tanks

New application; no submission date listed

Not yet submitted

Storage Tank Registration/Permitting

No submission date listed

Not yet submitted

The two issued entries are transfers. They show that existing environmental authorizations have moved through the transfer process, which is useful progress for a property with prior development work. They should not be described as two newly issued approvals for every element of Nebius's final campus design.

The pending Chapter 102 amendment and the unsubmitted categories show unfinished work. The tracker does not identify the construction phase served by each entry or provide a complete municipal building-permit schedule. Consequently, eight entries are not eight equivalent approvals, and “two of eight” would be a misleading completion percentage. Some approvals may be needed before particular work starts, while others may follow later in a staged build.

The positive conclusion is that Highridge has an environmental-permit history and completed transfers to build on. The concern is that the state still describes the project as under review, with several categories awaiting submission. The next meaningful update would connect those applications to a phase-specific construction and commissioning schedule.

Pennsylvania has changed the permitting environment

The August zoning decision occurred in the same month as a statewide policy change. Governor Shapiro's August 18 executive order established a new permitting approach for large data centers, including projects with peak demand above 25 MW. Its operative permitting provisions apply to applications submitted after the order's effective date. Executive Order 2026-05, particularly pages 3 and 4.

The order creates two different routes. Projects entering a project-specific GRID consent order and agreement can receive rolling permit review, but issuance still depends on the local land-use approvals and other requirements specified in the order. Projects outside that agreement process face a more restrictive sequence: required local and water-related authorizations before review, and all necessary DEP applications received and reviewed before permits can be issued through that route.

This is particularly relevant to a campus being developed in phases. Highridge's May transfer applications and August 7 amendment predate the order. Later applications may fall under the new framework. An older permit does not establish that every subsequent building, amendment or expansion is exempt.

The executive order also removed data centers from the state's Fast Track permitting program. It does not itself impose a blanket moratorium on Highridge. Nor does its cost-responsibility policy establish that this site must generate all of its electricity on the property. The important project-specific question is which route Nebius will use for the remaining applications and whether the sequence supports its delivery targets.

A Highridge-specific GRID agreement has not been publicly identified. That is a document worth obtaining because it could clarify both the commitments attached to the project and the handling of the remaining state permits.

Moratorium risk: the county and the phase matter

There are multiple Butler Townships in Pennsylvania. Highridge is in Schuylkill County. The Butler Township website carrying the May 12, 2026 municipal curative-amendment notice identifies itself as Luzerne County. That notice must not be attached to Highridge because the township names happen to match. Luzerne County township page and notice links.

No Highridge-specific moratorium has been established from the records used here. The August expansion of the local data-center district is affirmative evidence of a route forward. It also leaves later development approvals important, because permission for a land use is different from approval of every phase of a particular plan.

In its Q3 deck, Nebius said it did not expect the U.S. election to affect its projects, explicitly including Pennsylvania. That assessment addresses the political outlook. The local development plan, remaining environmental applications and utility work will determine the next Highridge milestones. Q3 shareholder deck.

Two state proposals deserve separate treatment. Senate Bill 1345 would allow qualifying municipalities to adopt temporary moratoriums of up to 18 months. Its amended text protects municipal applications or permits previously approved or granted before a moratorium takes effect and contains a separate exception for qualifying agreements to co-locate with a power-generation facility. An ordinary utility-service agreement is not evidence that the latter exception applies. The bill's listed latest action is a September 30 referral to Rules and Executive Nominations; it is a proposal, not enacted law. SB 1345 status; amended text, PN 1889.

Senate Bill 1359 proposes a broader 36-month statewide pause covering new data-center construction and expansion, along with certain power infrastructure. Its text would restrict accepting or issuing the covered approvals regardless of when an application was received. The listed action remains referral to Local Government on June 4. This also remains a proposal. SB 1359 status; proposed text, PN 1770.

Neither proposal justifies writing that Highridge has been stopped. They do explain why the precise date and scope of each approval matter. Earlier phases with valid approvals may have a different position from later phases still requiring new applications. The existing zoning overlay and transferred environmental authorizations improve the starting position, but they do not establish blanket protection for all 1.2 GW.

Water, sound and the neighboring communities

Highridge's industrial location does not remove its effects on nearby communities. Large fans, electrical equipment, backup systems, construction traffic and changes to drainage can all matter beyond the property boundary. Those issues shaped the August hearing and will remain part of the development process.

Nebius describes closed-loop liquid cooling intended to limit water demand. A closed loop recirculates coolant through equipment; it does not make all water needs disappear. Water still has to be supplied for the functions the final design requires, and stormwater must be managed across the developed land. The draft site plan's wetlands and retention areas show why drainage is part of the campus design rather than an incidental detail. Company design materials; project fact sheet.

At the August hearing, local representatives discussed approximately 37,000 gallons per day of water demand. That figure needs a defined development scope before it can be treated as consumption for the entire completed campus. The relevant questions are the phase covered, average versus peak demand and the obligations in the final supply arrangements.

The hearing account also reports a reduction in the property-line noise limit from 75 to 65 dBA, alongside a requirement for good-faith community-benefit negotiations during development review. These are practical obligations for the final mechanical and acoustic design. Predictive sound levels presented by a developer are useful design evidence; compliance has to be demonstrated under the conditions required by the approvals. August 31 hearing account.

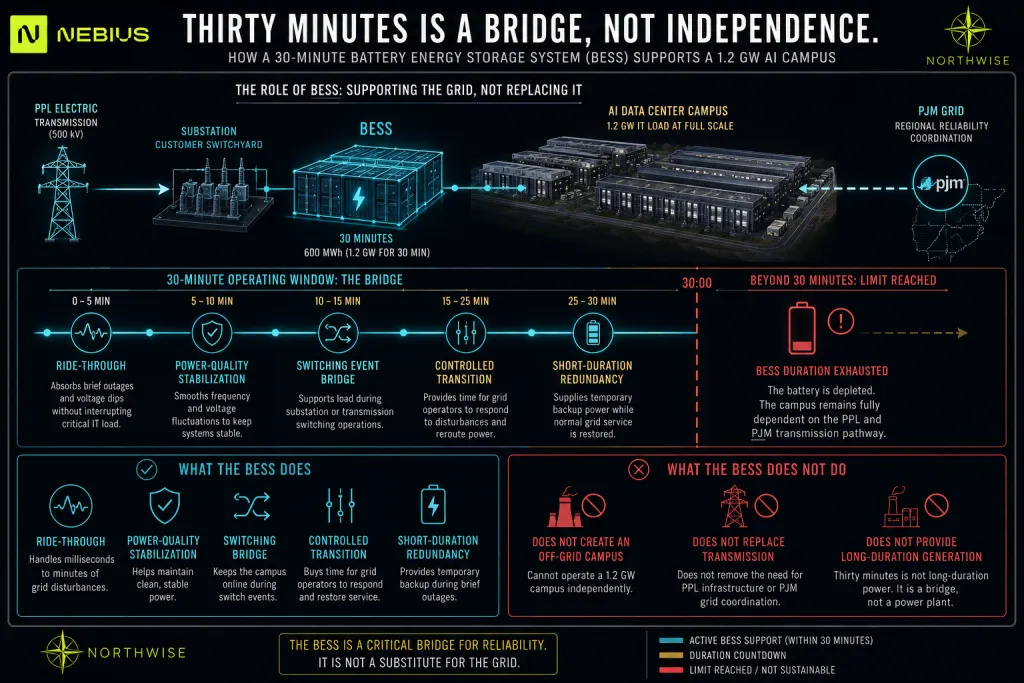

Backup-power equipment deserves the same attention. Battery systems and generators perform different roles, and a battery's short-duration support does not establish the absence of combustion equipment. DEP's air-quality and storage-tank categories make the final equipment schedule worth following. The report should be updated from those applications once their scope becomes public, rather than assuming a particular generator fleet or emissions profile today.

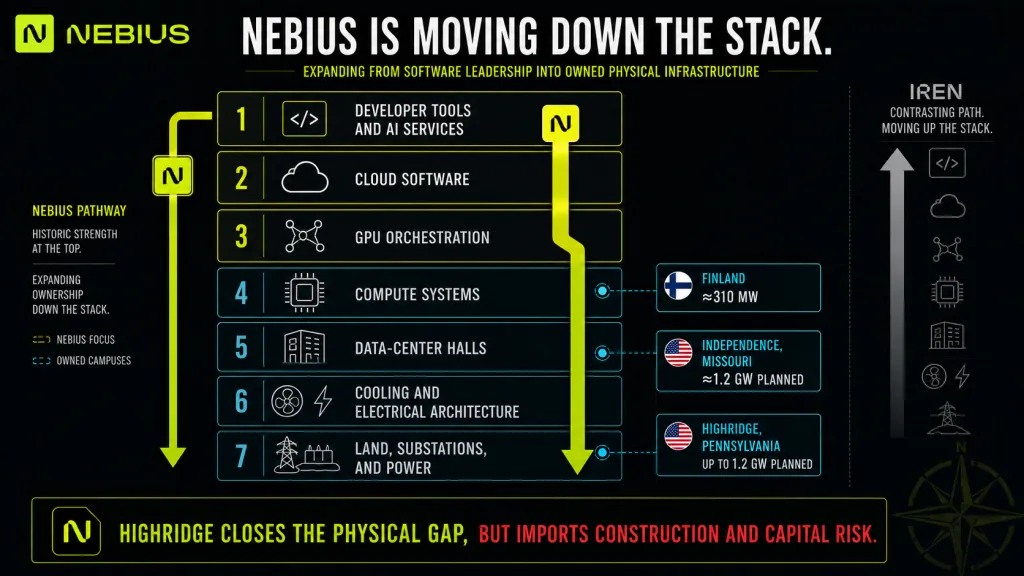

Why Highridge matters to the wider Nebius buildout

Nebius is assembling capacity through several routes at once. Smaller colocation facilities can provide access to established infrastructure. Owned developments give it more control over the long-term physical platform. Different regions, utilities and development partners create different opportunities and dependencies.

Highridge and Independence, Missouri, are part of Nebius's growing network of owned campuses. The company expects owned sites to make up most of the capacity it brings online from 2027 onward. Smaller provider-led projects like CLT1 in South Carolina give Nebius another way to add computing capacity while its larger campuses work through land, power and construction milestones. Independence site report · CLT1 site report · Q3 shareholder deck.

That diversification does not make individual delays harmless. A customer waiting for a large, purpose-built cluster may not be interchangeable with capacity available in another country or a smaller facility. Geography, latency, hardware, contract terms and cluster size can all constrain where demand can be served. Highridge's eventual contribution therefore depends on the specific product and customer capacity it can deliver, not simply its place in a global megawatt total.

No named Highridge customer allocation is established in the company materials cited here. Nebius's broader customer commitments support the strategic reason for expanding its physical footprint, but they should not be relabeled as a Pennsylvania lease or revenue contract. The future customer disclosure, if one is made, should be assessed alongside the delivery dates and acceptance obligations.

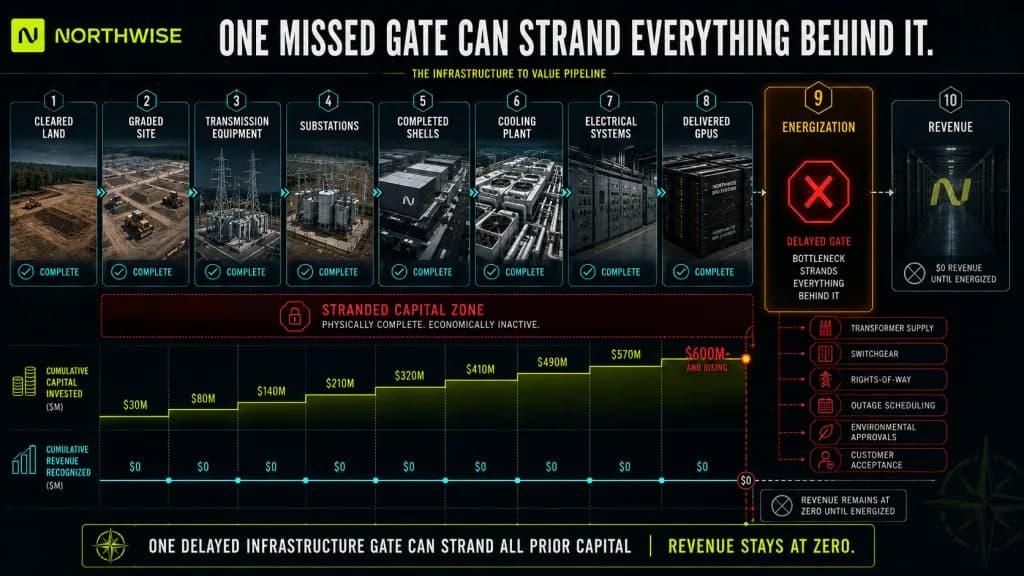

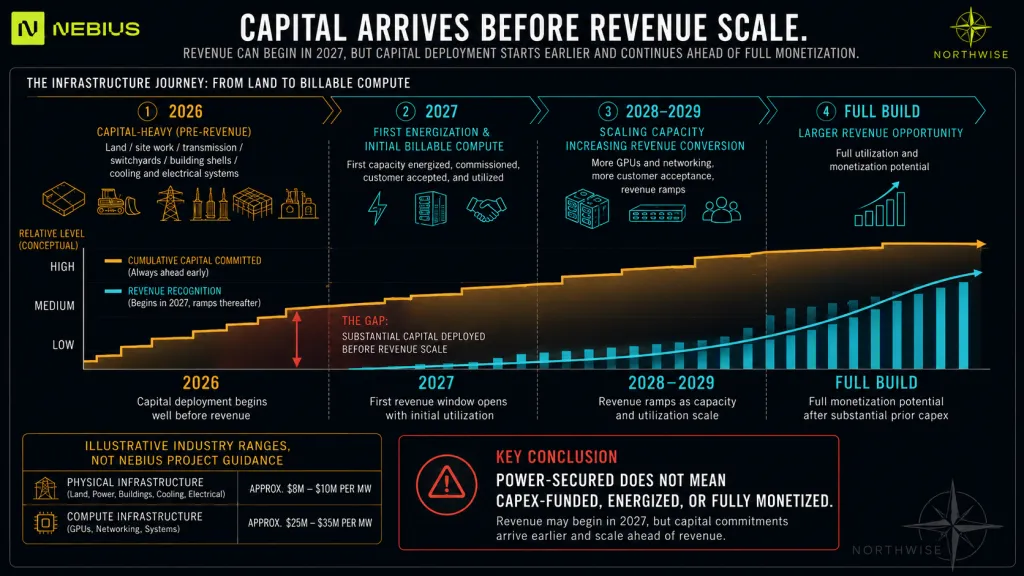

The capital question follows the construction schedule

Ownership offers control and potentially better long-term economics, but it puts substantial spending ahead of revenue. Land, civil work, buildings, electrical systems and cooling have to be financed before the installed compute can earn an adequate return.

Nebius's company-wide capital expenditure rose from approximately $5.7 billion in Q2 2026 to $7.3 billion in Q3. Its November outlook calls for $40 billion to $45 billion of company-wide capex in 2027. Management expects customer prepayments and asset-backed financing against existing investment-grade contracts to cover 75% to 85% of that spending. In July, Nebius raised a $775 million secured facility against deployed GPU infrastructure and contracted cash flows. Highridge's own construction budget and funding mix are undisclosed. Q2 shareholder letter · Q3 shareholder deck.

Customer funding can reduce the amount Nebius has to raise elsewhere. It also creates delivery obligations. If electrical or construction work slips after hardware has been ordered, cash can be tied up in equipment before the associated service starts earning revenue. Financing availability, procurement timing and customer acceptance need to move together.

The local investment figures discussed around Highridge are not a reconciled company budget. Likewise, the $231.65 million conceptual transmission estimate from the unnamed Gordon request is not the total cost of building and equipping a 1.2 GW campus. Combining land, utility and hardware estimates without matching their scope would give a precise-looking total with little analytical value.

The original study connected Highridge with a broader sector thesis: Nebius brings cloud software and operating capability to a market where control of the physical infrastructure increasingly matters. That interpretation remains the reason to study the campus closely. The return to shareholders will depend on the cost, timing and financing of the usable capacity produced, rather than the size of the announcement alone.

The milestones that would change the assessment

Highridge has cleared meaningful early hurdles. The acquired core, expanded overlay and environmental transfers give it a firmer base than a project still trying to secure a site. The current weak points are more specific: incomplete permit submissions, an unverified final approval sequence, the remaining expansion-land record and the need for up-to-date utility execution evidence.

Next evidence

What it would establish

Recorded expansion deed and final parcel plan

Whether the proposed Phase 3 land has closed and exactly what is included

Final land-development approvals and building permits

Which phase can proceed, on what conditions and with which construction scope

DEP amendment decisions and remaining applications

How the final design fits the transferred permits and the post-August permitting framework

Project-specific GRID agreement, if pursued

The commitments and review process applying to the remaining state applications

Updated PPL project status and customer-service evidence

The connection between the campus and utility works, with a current delivery sequence

Initial energization and commissioning disclosures

How much power and usable IT capacity have actually entered service

Customer assignment and acceptance schedule

The link from completed facilities to contracted service and revenue

A pending application is not, by itself, evidence of a missed deadline. Nor is a new approval proof that every remaining task will finish on time. The most useful updates will show how a particular milestone changes the path to October 2027 and the subsequent ramp.

Highridge could become a substantial operating asset for Nebius over the next several years. It has the proposed scale and physical room to matter well beyond one deployment. For now, its investment significance lies in whether the company can turn the owned core and initial power target into a working campus, then repeat that process across the later phases. The permits, electrical works and commissioning record will show how much of that ambition is becoming usable infrastructure.

Follow Highridge in the data-center tracker, compare its role with the other campuses in the Nebius site hub, and use the Nebius research and model library to examine the company-level assumptions. Site milestones and valuation assumptions should stay connected through their year and capacity basis.
